Project Notifications
Project Updates
Road Improvement Works Successfully Completed
The rebuilding and reinforcement works on public roads L1202 and L5204 have now been successfully completed by Coffey.
The project included resurfacing and associated civil engineering works to enhance the condition and durability of the local road network. Following the completion of these works, all affected road sections have been fully reopened to public and local resident traffic.
The roads are now operating as normal, restoring safe and continuous access for road users while meeting all relevant local authority requirements.
We would like to thank local residents, landowners and road users for their patience and cooperation throughout these works.
Road improvement and enabling works for the Quarry Lane Grid Stability Project have progressed well and are now nearing completion.
The current phase of works is scheduled to be completed by 25th September, with the road expected to reopen this week.
We'd like to thank local residents, businesses, and road users for their patience and cooperation while these works have been undertaken.
The project team remains committed to keeping the community informed as the project progresses and will continue to work closely with stakeholders throughout the next stages of construction.
Water network improvement works on behalf of Geevagh / Highwood Group Water Scheme Ltd. will commence on Monday, 31 August and are expected to take up to two weeks to complete.
During this period, temporary water supply interruptions may be required. Affected customers will be notified in advance, with interruptions expected to last approximately two hours.
Geevagh / Highwood Group Water Scheme Ltd. thanks residents for their patience and understanding while these essential improvements are undertaken.

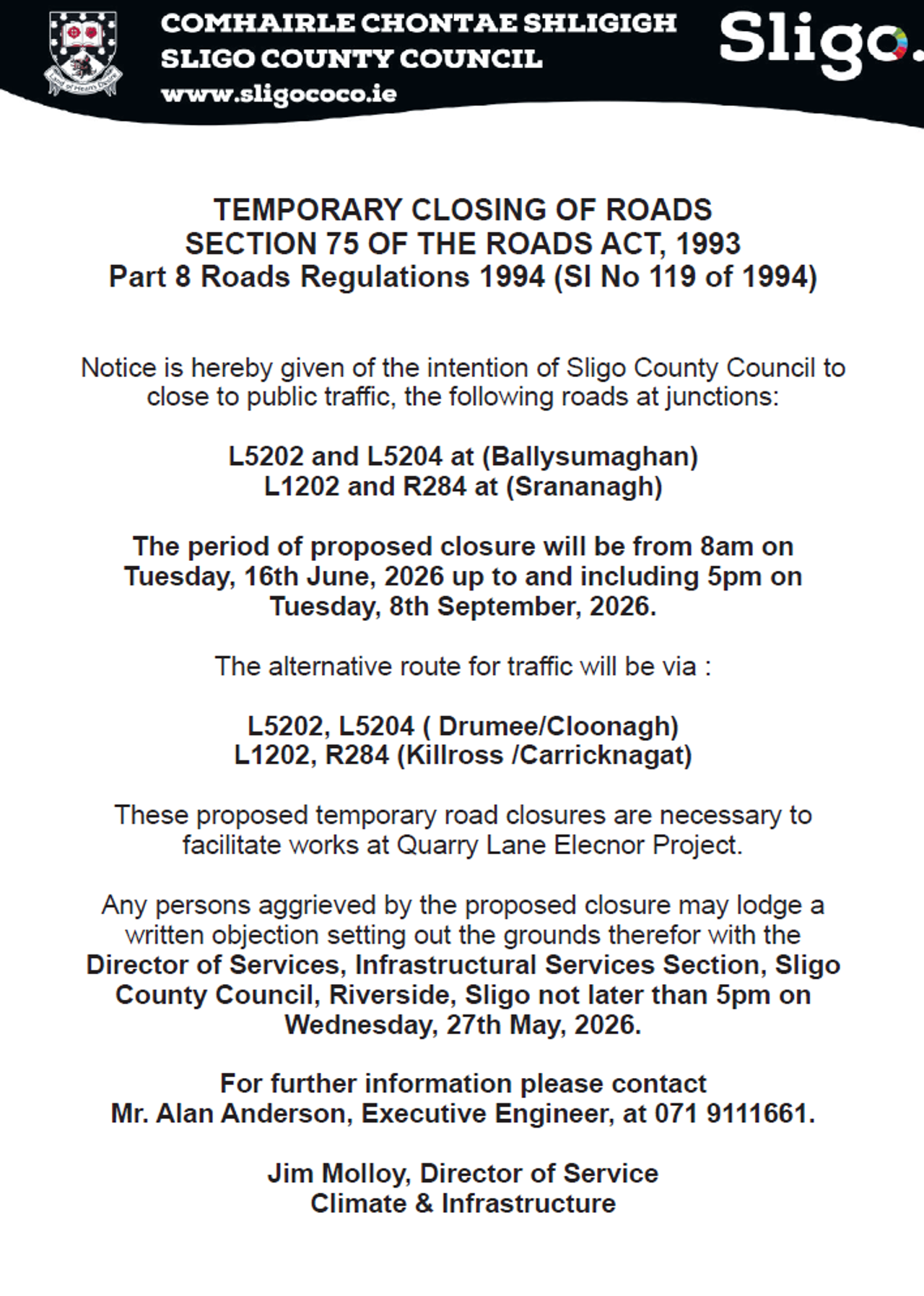

There will be some road closures in the area in the coming weeks, we apologise for any incovienice and thank you for your understanding.
- Road: L5204
- Closure Start Date: 28th August
- Expected Duration: 3 to 4 weeks
- Reason: Essential construction/road works

- Diversions: Signposted where applicable

Resurfacing works on the L1202 from Sooey to the L5204 junction are scheduled to be completed during the week of August 24th, ensuring the road is ready for the reopening of the local school.
We'd like to thank residents, road users and the wider community for your patience and cooperation throughout these works.
Start time: 4:00am | Full day pour
Works will be carried out in accordance with the approved Traffic Management Plan agreed with Sligo County Council. Construction traffic associated with this pour will use the L5204 and L1202 roads.
We appreciate your patience during this period. If you have any questions or concerns regarding these works, please don't hesitate to get in touch.
The Resurfacing of the L1202 from Sooey to the cross at L5204 will commence the week of the 27th July and will continue for approximately 3 weeks.
We appreciate your patience and continued cooperation during this period.
The proposed Quarry Lane concrete pour due to commence the week of July 13th has been postponed until July 30th/31st.
We appreciate your patience and continued cooperation during this period.
Concrete Pour — Week commencing 13th July
Works will be carried out in accordance with the approved Traffic Management Plan agreed with Sligo County Council. Construction traffic will use the L5204 and L1202 roads.
Please be advised that there will be additional HGV traffic in the area for the duration of these works. We appreciate your patience and continued cooperation during this period

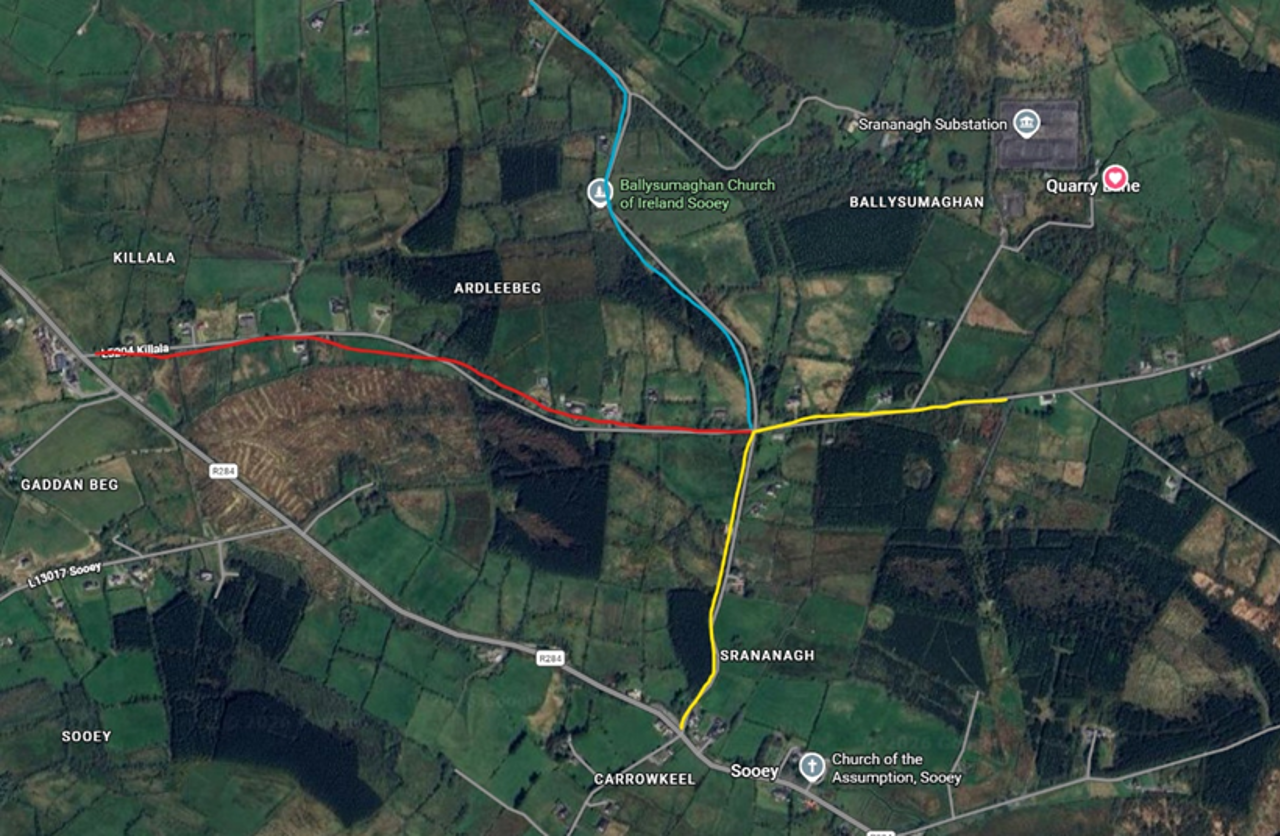

Road Repair/Upgrades.
· Red line: Resurface now completed by the council
· Blue line: Council addressed problem areas
· Yellow line: The upgrading of this road will be completed Q2 2026

· There will be a concrete pour week commencing 22nd June, resulting in a larger volume of HGV traffic.
· Delivery of a crawler Crane to site on the 12th of June
